The “Banana” GE Demolished To Build Malaysia’s Second USC Plant

August 26, 2017
Panorama of coal supply at Tanjung Bin power station.
By Hong Chou Hui

In the 1989 French Open’s fourth round, Michael Chang ate bananas and beat Ivan Lendl en route to become the youngest tennis Grand Slam champion, vaulting the humble tropical fruit into public consciousness. The banana, packed with vitamins, fiber and minerals, is loved by many around the world as a food and snack.

It also nearly prevented the successful construction of GE’s second ultrasupercritical coal power plant in southern Peninsular Malaysia in February 2013, when staff working on the Tanjung Bin 4 project found one in the foundations. The Tanjung Bin 4 plant is Southeast Asia’s second ultrasupercritical facility and work started on the $1.4 billion project in April 2012.

“February 2013 is when we discovered the big disaster,” says Antoine Erbacher, GE’s Senior Project Leadership Staff Manager who joined the project that same month as Deputy Project Director. “When we arrived to measure the alignment of the seven pulverisers’ foundations, they were supposed to be fully aligned in a straight line but instead they were lined up in a banana shape.” Pulverisers grind coal into powder before the fossil fuel is burnt to boil water and produce steam to drive turbines that generate electricity.

Guillaume Turc recalls hearing a loud bang, an impending sign of collapse, from supporting structures in an excavation ten meters deep where several hundred workers were evacuated before his arrival at the site.

“The ground conditions were so unpredictable that when you applied repeated stress to the soil, it would become liquid,” says Turc, GE’s Executive for Project Leadership, who lists Tanjung Bin 4 as one of the top three most challenging projects in his 24-year career.

A decision was made to demolish all the foundations that were laid and restart the construction process, despite the ensuing ten-month delay. The team combined the foundations of the pulverisers and boiler into one single piece via a redesign that increased the amount of concrete and steel used, raising construction costs. In addition, the liquidated damages for not being to complete the project on time was set at more than half a million dollars each day.

Under the leadership of Marc Villemin, GE Executive and Tanjung Bin Consortium Project Director, all forces were immediately mobilized and displayed an extraordinary energy to mitigate the impact from 2013 to this year.

To recover from the ten-month setback, the project’s schedule was overhauled with building processes happening in tandem and not sequentially unlike traditional construction, added Turc. Tanjung Bin 4’s turbine hall was built in this fashion, with cranes and excavators operating on a specially built deck that allowed digging to continue while the rest of the hall was erected.

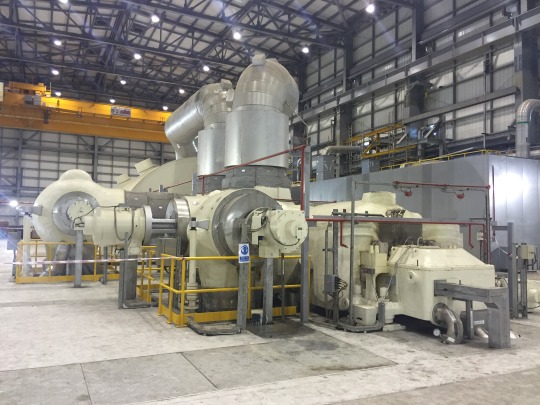

 width=

“It was extremely difficult managing all these teams and the different contractors and we had to get the A team,” says Erbacher who worked on Malaysia’s first ultrasupercritical plant at Manjung in Perak state. “There were drawings and plans on the walls in one dedicated room where everyone put a sticker to show where they were working, and these were moved everyday so we have daily or even twice a day coordination which was a huge effort.”

GE completed Tanjung Bin 4 on time and below budget before handing it over to Malakoff Corporation Bhd in April this year. The project’s 32 million man hours with a loss-time injury ratio of 0.31 is significant and lower than industry levels, says Erbacher.

“Recovering a ten-month delay in such difficult conditions does not come by chance” says Marc. “It is the result of the close collaboration of highly competent and motivated individuals who never accepted the unfortunate fate that marked our project.”

Local expertise, project management and best technology in the form of GE’s high efficiency ultrasupercritical technology enabled the Tanjung Bin 4 project to succeed by winning Coal Project of the Year which was awarded September 22. On the same day, GE received the EPC of the Year – Gold award for its role as the main contractor and consortium leader for the project.

“The team spirit and morale in the project office is very good, with lots of talk still about the recovery from the ten-month delay and it’s injected a lot of pride into everyone on site,” says Lucien Barrois, GE’s Consortium Site Manager, who joined the project at the start of 2015 as part of the plant’s commissioning process. “A lot of people including myself before I came here thought it wasn’t possible to recover from the delay.”

Today, Tanjung Bin 4 supplies 1,000MW of power to Malaysia and provides electricity to meet the needs of 2 million people, or 6% of the country’s energy demand. The facility operates GE’s state-of-the-art ultrasupercritical boiler along with a proprietary environmental control system, which enables the plant to operate at greater efficiency while lowering emissions such as nitrous oxide, dust and sulphur oxide.
